NEXT Energy

Pipeline

Seven projects, 392.5 MW.

Solar, onshore wind, and Georgia's first proposed offshore wind project. Stage, partner, and schedule for each—including the early ones.

Portfolio status

Every project, and the gate it has cleared

Solar Wind
ProjectLand & leaseGrid connectionPermitsOfftakeReady to buildConstructionOperation
Udabno Solar PV5 MW · Solar PV
Iliatsminda Solar PV26 MW · Solar PV
Kutaisi Solar PV3.5 MW · Solar PV
Kutaisi Wind22.5 MW · Onshore wind

Co-located — one 110/35 kV substation, one 110 kV line, 26 MW behind a single connection

Egrisi Solar PV110 MW · Solar PV
Kareli Wind30 MW · Onshore wind
Poti Offshore Wind195.5 MW · Offshore wind

Marker shows the last gate cleared. Scroll sideways on a narrow screen.

ProjectTechnologyGrid (AC)NameplateLocationPartnerNext gateTarget COD
Udabno Solar PVSolar PV5 MW6.4 MWpSagarejo, KakhetiGeorgian Energy Development Fund (GEDF)Commercial operation, September 2026September 2026
Iliatsminda Solar PVSolar PV26 MW32.9 MWpSighnaghi, KakhetiOHM Energy LTD (Armenia)Ready to build, November 2026December 2027
Kutaisi Solar PVSolar PV3.5 MW5.25 MWpTerjola, ImeretiGURIS Renewables LLCReady to build, November 2026December 2027
Kutaisi WindOnshore wind22.5 MW22.5 MWTerjola, ImeretiGURIS Renewables LLCReady to build, April 2027December 2027
Egrisi Solar PVSolar PV110 MW155 MWpSamtredia, ImeretiSUNGROW RenewablesCfD memorandum with the Government of GeorgiaTo be confirmed
Kareli WindOnshore wind30 MW30 MWKareli, Shida KartliHUBEI TITAN Zero-Carbon Technology LTDReady to build, May 2027December 2027
Poti Offshore WindOffshore wind195.5 MW195.5 MWBlack Sea, off PotiOpen — seeking offshore partnerMemorandum enabling full feasibilityTo be confirmed

Project detail

Where each one stands

Site footage · Sagarejo

Udabno Solar PV

Solar PV 6.4MWp

Construction began in May 2026 and is largely complete. Udabno is the first NEXT Energy plant to reach commercial operation and the reference case for everything behind it in the pipeline.

Grid capacity
5 MW AC
Location
Sagarejo, Kakheti
Project company
Georgian Solar Company LLC
Partner
Georgian Energy Development Fund (GEDF)
EPC contractor
OHM Energy LLC (Georgia)
Construction management
ENGIA Green LLC
Next gate
Commercial operation, September 2026
Ready to build
Cleared
Construction
May 2026
Target COD
September 2026
Iliatsminda Solar PV

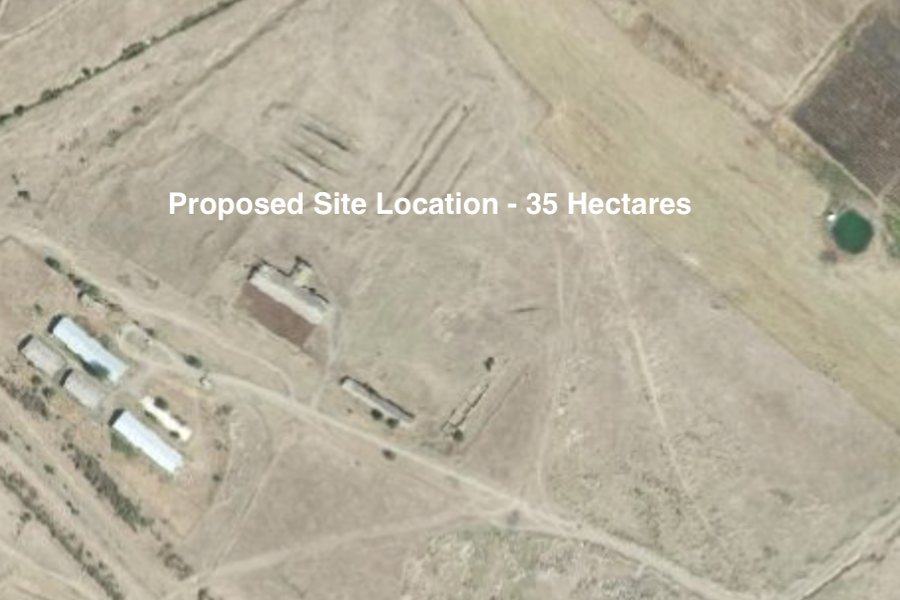

Proposed site · 35 hectares

Iliatsminda Solar PV

Solar PV 32.9MWp

The largest of the near-term solar projects. Development is running on the same schedule as Kutaisi Solar, which lets the two share procurement and construction management.

Grid capacity
26 MW AC
Location
Sighnaghi, Kakheti
Project company
Qiziki Solar LLC
Partner
OHM Energy LTD (Armenia)
EPC contractor
OHM Energy LLC (Georgia)
Construction management
ENGIA Green LLC
Next gate
Ready to build, November 2026
Ready to build
November 2026
Construction
March 2027
Target COD
December 2027
Kutaisi Solar PV
Reference image

Kutaisi Solar PV

Solar PV 5.25MWp

One half of a co-located hybrid. Kutaisi Solar and Kutaisi Wind sit on adjacent land in Terjola, are held in the same company, and export through a single shared 110/35 kV substation and 110 kV transmission line. The solar side runs roughly six months ahead of the wind side.

Grid capacity
3.5 MW AC
Location
Terjola, Imereti
Project company
Aia Wind LLC
Partner
GURIS Renewables LLC
Grid connection
Shares a 110/35 kV substation and 110 kV line with Kutaisi Wind
Next gate
Ready to build, November 2026
Ready to build
November 2026
Construction
March 2027
Target COD
December 2027
Kutaisi Wind
Reference image

Kutaisi Wind

Onshore wind 22.5MW

The wind half of the Terjola hybrid. Together with Kutaisi Solar it puts 26 MW of generation behind one grid connection, on two resources that rarely peak at the same hour — so the shared connection and line carry more energy than either plant would justify on its own.

Grid capacity
22.5 MW AC
Location
Terjola, Imereti
Project company
Aia Wind LLC
Partner
GURIS Renewables LLC
Grid connection
Shares a 110/35 kV substation and 110 kV line with Kutaisi Solar
Next gate
Ready to build, April 2027
Ready to build
April 2027
Construction
May 2027
Target COD
December 2027
Egrisi Solar PV
Reference image

Egrisi Solar PV

Solar PV 155MWp

The largest project in the portfolio. The site is in Samtredia; the grid connection is at Tskaltubo, reached by an 11 km transmission line built as part of the project. The connection agreement with GSE is signed and the pre-feasibility study is submitted. The project is waiting on the contract-for-difference memorandum with the Government of Georgia, which is the gate that sets its schedule.

Grid capacity
110 MW AC
Location
Samtredia, Imereti
Project company
Egrisi Solar LLC
Partner
SUNGROW Renewables
Grid connection
Connects at Tskaltubo via an 11 km transmission line
Next gate
CfD memorandum with the Government of Georgia
Ready to build
To be confirmed
Construction
To be confirmed
Target COD
To be confirmed
Kareli Wind
Reference image

Kareli Wind

Onshore wind 30MW

A memorandum with HUBEI TITAN was signed recently. Measurement and permitting run through 2026 into early 2027.

Grid capacity
30 MW AC
Location
Kareli, Shida Kartli
Project company
Kareli Wind LLC
Partner
HUBEI TITAN Zero-Carbon Technology LTD
Next gate
Ready to build, May 2027
Ready to build
May 2027
Construction
June 2027
Target COD
December 2027
Poti Offshore Wind
Reference image

Poti Offshore Wind

Offshore wind 195.5MW

The first offshore wind project proposed in Georgia. The pre-feasibility study is submitted and a memorandum with the Government of Georgia is in negotiation to open detailed feasibility work. Early stage, and described as such.

Grid capacity
195.5 MW AC
Location
Black Sea, off Poti
Project company
Black Sea Wind LLC
Partner
Open — seeking offshore partner
Next gate
Memorandum enabling full feasibility
Ready to build
To be confirmed
Construction
To be confirmed
Target COD
To be confirmed

On the Terjola hybrid. Kutaisi Solar and Kutaisi Wind are adjacent sites in one company, exporting through a shared 110/35 kV substation and 110 kV line. Grid capacity is the scarce input in Georgian development, and a connection carrying both resources runs at a higher load factor than either would alone — the same interconnection asset, more energy through it, one set of civil and electrical works. For an investor it is a single 26 MW position; for an EPC it is one mobilisation.

On these dates. Ready-to-build, construction and commercial operation dates are development targets under the current schedule, not commitments. They move when gates move. Anything not yet underwritten is shown as to be confirmed rather than estimated. The table is reviewed quarterly.
